How to Use Microsoft Project 2024: Complete Beginner Guide

How to Use Microsoft Project 2024: Complete Beginner Guide
Published: July 20, 2026

Microsoft Project 2024 helps turn a simple list of activities into a structured project plan with dates, dependencies, resources, milestones, and progress tracking.

The interface may feel a little overwhelming when you first open it, but beginners only need to understand a handful of core features to create a useful schedule.

This Microsoft Project 2024 tutorial walks you through the essential workflow using a website launch as an example. By the end, you will know how to create tasks, build a Gantt chart, link activities, assign resources, save a baseline, and track progress.

You can also read our best project management software guide to see how Microsoft Project compares with other popular planning tools.

Quick Answer: How Do You Use Microsoft Project 2024?

To use Microsoft Project 2024, create a blank project, set the project start date, enter your tasks and durations, organize the work into phases, link dependent tasks, add milestones, and assign resources.

Before work begins, save a baseline. As the project progresses, update each task and compare the current schedule with the original plan.

What Is Microsoft Project 2024?

Microsoft Project 2024 is desktop project management software designed for planning, scheduling, and monitoring projects.

It includes pre-built templates, automated scheduling, dependency-based date calculations, Gantt chart task paths, baselines, built-in reports, and multiple timelines. It is available as a perpetual purchase for one Windows PC rather than as an ongoing subscription.

Microsoft Project is particularly useful when a project involves:

  • Multiple tasks that must happen in a specific order

  • Fixed deadlines or important milestones

  • People, equipment, or costs that need to be managed

  • Tasks whose delays could affect the final delivery date

  • A need to compare the approved plan with actual progress

If you're comparing editions or looking to buy a Project 2024 product key, visit our Microsoft Project 2024 category page to explore available versions and compare features.

Understanding the Microsoft Project 2024 Interface

When you open a blank project, the default Gantt Chart view is divided into several important areas:

  • Task table: The grid on the left where you enter task names, durations, dates, and predecessors.

  • Gantt chart: The timeline on the right that displays tasks as horizontal bars.

  • Ribbon: The toolbar containing tabs such as Task, Resource, Project, Report, and View.

  • Timeline: A high-level visual summary of important tasks and milestones.

  • Status bar: The area at the bottom of the screen where you can change views and adjust the zoom level.

For your first project, remain in Gantt Chart view. It combines the task list and visual schedule, making it the easiest workspace for learning the basics.

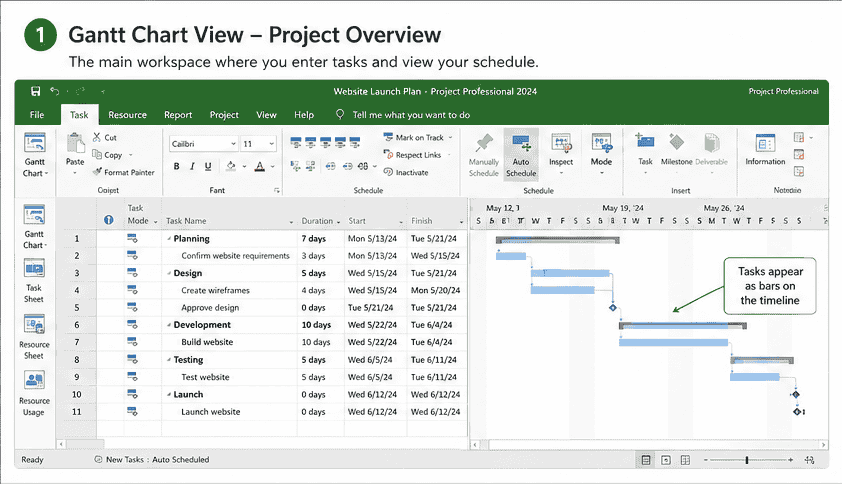

Microsoft Project 2024 Gantt Chart view

How to Create a Project Plan in Microsoft Project 2024

The following beginner tutorial uses a website launch as the sample project.

1. Create a Blank Project

Open Microsoft Project 2024 and select:

File > New > Blank Project

Save the file immediately using a clear name, such as:

Website Launch Plan.mpp

Saving early may seem like a tiny step, but it is much better than building half a project plan only to lose it to an unexpected restart.

2. Set the Project Start Date

Go to:

Project > Project Information

Choose the planned start date and confirm that the project is scheduled to start on that date. Microsoft Project will use it as the starting point when calculating the rest of the schedule.

Avoid entering fixed start and finish dates for every task. Where possible, allow Project to calculate dates using durations, calendars, and task relationships.

This keeps the schedule flexible. When one task changes, Project can automatically adjust the tasks connected to it.

3. Enter the Main Tasks and Durations

In the Task Name column, enter the activities required to complete the project. Add the estimated duration of each task in the Duration column.

Task Duration
Confirm website requirements 3 days
Create wireframes 4 days
Approve design 0 days
Build website 10 days
Test website 5 days
Launch website 0 days

You can enter durations using values such as:

  • 3d for three days

  • 2w for two weeks

  • 4h for four hours

Use task names that describe a clear action or deliverable. For example, Approve homepage design is more useful than a vague label such as Design work.

Clear task names make the plan easier to understand when you return to it later or share it with someone else.

4. Organize Tasks into Phases

Larger project plans are easier to follow when tasks are grouped into phases.

For the website project, you might use:

  • Planning

  • Design

  • Development

  • Testing

  • Launch

Place the relevant activities below each phase. Select those activities and choose:

Task > Indent Task

The phase becomes a summary task, while the intended activities become subtasks.

Do not manually enter a duration for a summary task. Microsoft Project calculates its date range from the subtasks beneath it.

5. Use Automatically Scheduled Tasks

For most beginner projects, use Auto Scheduled task mode.

This allows Microsoft Project to recalculate dates whenever a duration, dependency, or calendar changes.

To change a manually scheduled task, select it and choose:

Task > Auto Schedule

Automatic scheduling turns your project into a connected plan rather than a static spreadsheet. Adjust one task, and the rest of the schedule can respond accordingly.

A dependency tells Microsoft Project how one task relates to another.

For example, website development should not begin until the design has been approved.

To link tasks:

  1. Select the tasks in the order they should occur.

  2. Open the Task tab.

  3. Select Link Tasks.

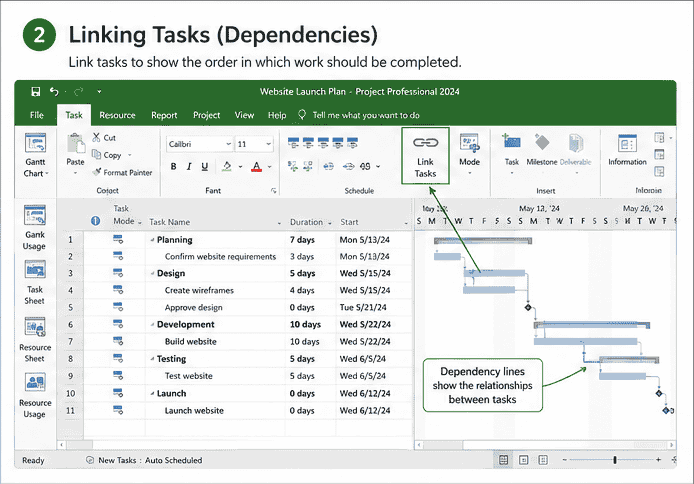

Link Tasks in Microsoft Project 2024

The most common dependency types are:

Dependency Meaning
Finish-to-start Task B starts after Task A finishes
Start-to-start Task B starts when Task A starts
Finish-to-finish Task B finishes when Task A finishes
Start-to-finish Task B cannot finish until Task A starts

Finish-to-start is the most common relationship and the best option for beginners to learn first.

Once tasks are linked, Microsoft Project can calculate their dates and display the relationships visually in the Gantt chart.

7. Add Project Milestones

A milestone marks an important event, approval, or deadline.

Examples include:

  • Requirements approved

  • Design approved

  • Testing completed

  • Website launched

To create a milestone, enter it as a task and set its duration to 0 days.

It will appear as a diamond on the Gantt chart.

Milestones make it easier to communicate important decision points without adding extra work duration to the schedule.

8. Review the Gantt Chart

Look at the right side of the screen. Your Gantt chart should now display:

  • Bars representing task durations

  • Lines connecting dependent tasks

  • Diamonds representing milestones

  • Summary bars covering each project phase

Use the zoom control or adjust the timescale if the schedule looks too compressed.

A short project may be easier to read in days or weeks, while a longer project may need a monthly view.

How to Assign Resources to Tasks

Resources can include people, equipment, materials, and project costs.

Create a Resource List

Go to:

View > Resource Sheet

Enter each resource in the Resource Name column.

For the website project, you might add:

  • Project manager

  • Designer

  • Developer

  • Content writer

  • Tester

You can also enter each resource’s availability and hourly rate to estimate workloads and labor costs.

Assign Resources

Return to Gantt Chart view, select a task, and choose:

Resource > Assign Resources

Select the appropriate person and click Assign.

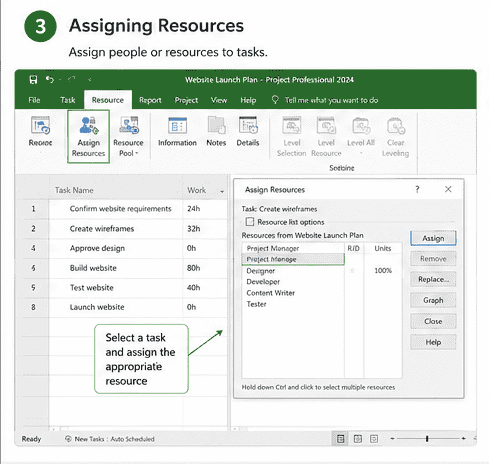

Assign Resources in Microsoft Project 2024

Assigning resources makes it clear who is responsible for each task. It can also reveal overallocations, such as one developer being assigned to several full-time tasks during the same period.

How to Save a Baseline

A baseline is a snapshot of the approved project plan.

It stores the planned schedule so you can later compare it with what actually happened.

Once the plan has been reviewed and approved, select:

Project > Set Baseline > Set Baseline > Entire Project

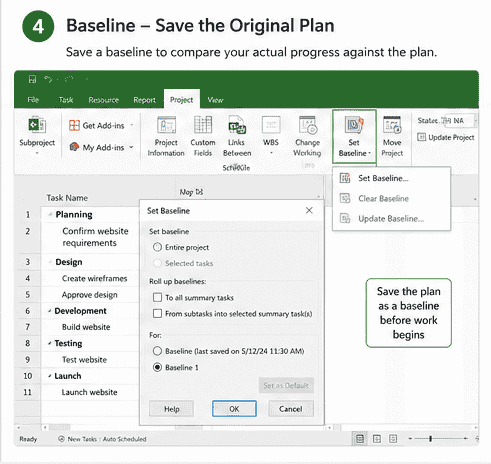

Set Baseline in Microsoft Project 2024

Do not overwrite the original baseline after every routine change. Keeping it intact allows you to measure genuine schedule variance.

Save another baseline only when a revised plan has been formally reviewed and approved.

How to Track Project Progress

A project plan becomes truly useful when it is updated consistently.

Set the Status Date

Select:

Project > Status Date

The status date is the point up to which progress is being reported.

For example, if you are reviewing the project on Friday, you might set the status date to that Friday.

Update Task Completion

You can record progress using:

  • Percentage complete

  • Actual start date

  • Actual finish date

  • Actual duration

  • Remaining duration

For a quick update, enter a value in the % Complete column or use the completion buttons on the Task tab.

Only mark a task as 100% complete when it is genuinely finished. If work remains, update the remaining duration so the schedule reflects reality rather than optimism wearing a hard hat.

Compare Planned and Actual Progress

Open:

View > Tracking Gantt

This view compares the current schedule with the saved baseline and can help you identify:

  • Tasks that started late

  • Work that is taking longer than planned

  • Milestones that may be at risk

  • Changes to the projected project finish date

How to Show the Critical Path

The critical path is the sequence of tasks that currently determines the project’s finish date.

If a critical task is delayed and has no available slack, the entire project may finish late.

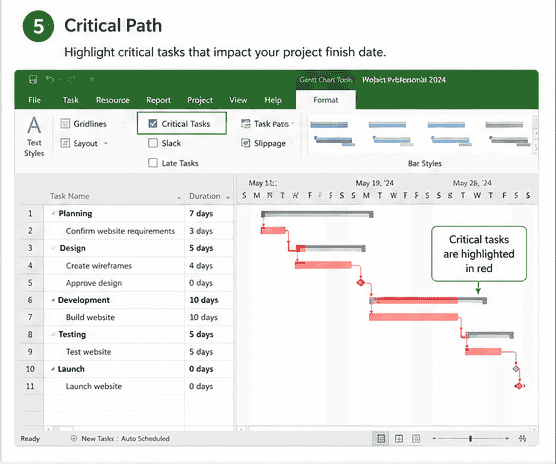

In the Gantt Chart view, open the Format tab and enable Critical Tasks.

Critical Tasks in Microsoft Project 2024

Review the critical path regularly. It can change when you update task durations, dependencies, calendars, or actual progress.

How to Create Reports and Share the Project

Open the Report tab to explore built-in reports covering project progress, work, resources, and costs.

Microsoft Project 2024 also supports multiple timelines and allows you to copy project information into other Microsoft Office applications.

You can also:

  • Add important tasks to the Timeline for a management summary

  • Copy project information into Word, Excel, or PowerPoint

  • Print the Gantt chart

  • Export the project as a PDF

  • Share the .mpp file with users who have compatible software

Before sharing a Gantt chart, hide unnecessary columns and adjust the timescale so the most important information is easy to read.

Microsoft Project 2024 Standard vs Professional

Both editions provide the core desktop tools needed to create schedules, manage task relationships, build Gantt charts, save baselines, and run reports.

Edition Best for Main consideration
Project Standard 2024 Individuals and smaller teams managing standalone desktop projects Core scheduling, baselines, timelines, and reporting
Project Professional 2024 Project managers and organizations using more advanced or connected Project environments Additional support for enterprise synchronization scenarios

For beginners who mainly need standalone desktop scheduling, Project Standard 2024 may be sufficient.

Project Professional 2024 is more suitable for project managers and organizations that require its additional connected-project capabilities.

Explore Microsoft Project LTSC 2024 Professional at Brytesoft to review its product details and system requirements.

Microsoft Project 2024 System Requirements

Microsoft lists the following requirements for Project Standard 2024:

Component Requirement
Processor 1.6 GHz or faster, 2-core
Memory 4 GB RAM or 2 GB for 32-bit
Storage 4 GB of available disk space
Display 1280 × 768 resolution
Graphics DirectX 10 for hardware acceleration
Operating system Windows 11, Windows 10, or Windows Server 2019
Additional requirements Internet access and a Microsoft account

Check the latest system requirements and confirm the compatibility of any existing Office, Visio, or Project installation before installing the software.

Common Microsoft Project Beginner Mistakes

Avoid these common planning traps:

  1. Entering fixed dates for every task: Use durations and dependencies so the schedule can respond to changes.

  2. Leaving tasks manually scheduled: Auto Schedule is usually more useful for a connected project plan.

  3. Creating tasks that are too large: Break lengthy activities into smaller, manageable deliverables.

  4. Forgetting milestones: Add zero-duration checkpoints for important approvals and deadlines.

  5. Assigning resources too early: Build the task structure and dependencies before assigning people.

  6. Not saving a baseline: Without one, it is difficult to compare planned and actual performance.

  7. Updating only percentage complete: Review the remaining duration and expected finish date as well.

  8. Ignoring the critical path: A delay to a critical task may affect the entire project.

  9. Adding unnecessary detail: Track meaningful work rather than every tiny action.

  10. Failing to review the plan: Update the schedule regularly so it continues to reflect reality.

Is Microsoft Project 2024 Worth It for Beginners?

Microsoft Project 2024 is worth considering when a project needs more structure than a basic checklist or spreadsheet can provide.

Its main strength is that tasks, dates, dependencies, resources, and milestones work together. When one part of the schedule changes, Project can recalculate the connected plan through its automated scheduling tools.

There is a learning curve, but beginners do not need to master every feature immediately.

Start with:

  • Gantt Chart view

  • Task durations

  • Dependencies

  • Milestones

  • Resources

  • Baselines

These features provide a strong foundation for most project plans.

Final Thoughts

Learning how to use Microsoft Project 2024 becomes easier when you follow one repeatable workflow:

  1. Set the project start date.

  2. Enter tasks and durations.

  3. Organize the work into phases.

  4. Link dependent tasks.

  5. Add milestones.

  6. Assign resources.

  7. Save a baseline.

  8. Update progress.

  9. Review the critical path.

  10. Share clear reports.

Start with a small, real-world project and keep the schedule simple. Allow Microsoft Project to calculate dates from task relationships rather than manually controlling every field.

Once the foundation is stable, you can gradually explore costs, resource leveling, custom fields, and more advanced reporting.

Verified

Verified Partners

Official keys at affordable prices.

Instant Delivery

Instant Delivery

Buy now and get your keys in seconds.

Live Support

24/7 Live Support

Our team is always here to assist.

Trusted Users

Trusted by 100k+ Users

Over 1 Million keys delivered worldwide.

FAQ About How to Use Microsoft Project 2024: Complete Beginner Guide

Is Microsoft Project 2024 suitable for beginners?

Yes. Beginners can start with a blank project or a pre-built template, then focus on tasks, durations, dependencies, and milestones. More advanced resources, cost, and reporting features can be learned later.

How do I create a Gantt chart in Microsoft Project 2024?

Open a blank project, enter your tasks and durations, and link activities that depend on one another. The Gantt Chart view will automatically display the tasks, dates, relationships, and milestones on a timeline.

How do I link tasks in Microsoft Project?

Select the tasks in the correct order and choose Task > Link Tasks. Microsoft Project normally creates a finish-to-start dependency, which means the second task begins after the first task finishes.

How do I add a milestone?

Enter the milestone as a task and set its duration to 0 days. It will appear as a diamond in the Gantt chart.

What is a baseline in Microsoft Project?

A baseline is a saved version of the approved project plan. It allows you to compare planned dates, work, and costs with actual project performance.

How do I show the critical path?

Open the Gantt Chart view, select the Format tab, and enable Critical Tasks. The highlighted tasks are those currently influencing the project finish date.

Is Microsoft Project included with Microsoft 365 or Office 2024?

No. Project Standard 2024 and Project Professional 2024 are separate products. Microsoft also offers subscription-based project management plans, so check the exact product and licensing model before purchasing.

Can Microsoft Project 2024 run on a Mac?

The desktop editions of Microsoft Project 2024 require Windows. Mac users would need access to a compatible Windows environment or a different project management solution.
